CONSTRUCTION IMAGE REPORT
PROJECT: NHỊ THÀNH WATER TREATMENT PLANT PHASE 3 - EXPANSION TO 120,000M³/DAY AND NIGHT
Construction Progress:
Raw Water Pipeline (D1200mm) along DT818 Road: Completed pipeline installation and asphalt restoration for 2,314m/2,327m. Overall construction and road restoration progress achieved 90%.
+ Raw Water Pipeline (D1200mm) from Overpass 7 to Overpass 3 (7,128m): Not yet started.
+ Clean Water Pipeline (D1200mm) along National Highway 1A: 1,974m/6,800m completed. Construction and road restoration progress achieved 29%.
+ Nhi Thanh Water Plant Construction:
Pile driving: 947/973 piles: completed 97% progress.

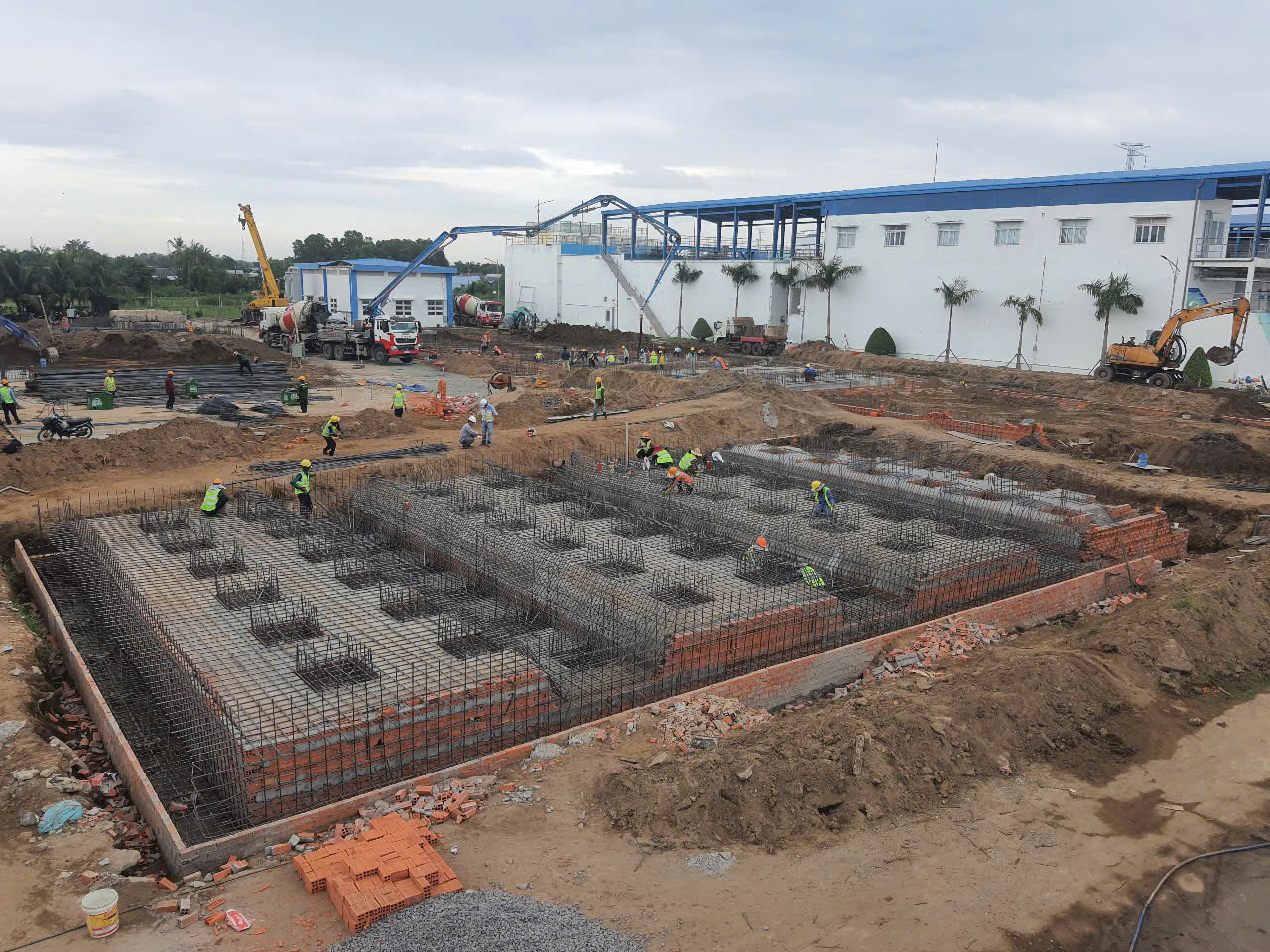

Foundation works for treatment unit structures: 10% progress.
1. Nhi Thanh Water Plant Construction

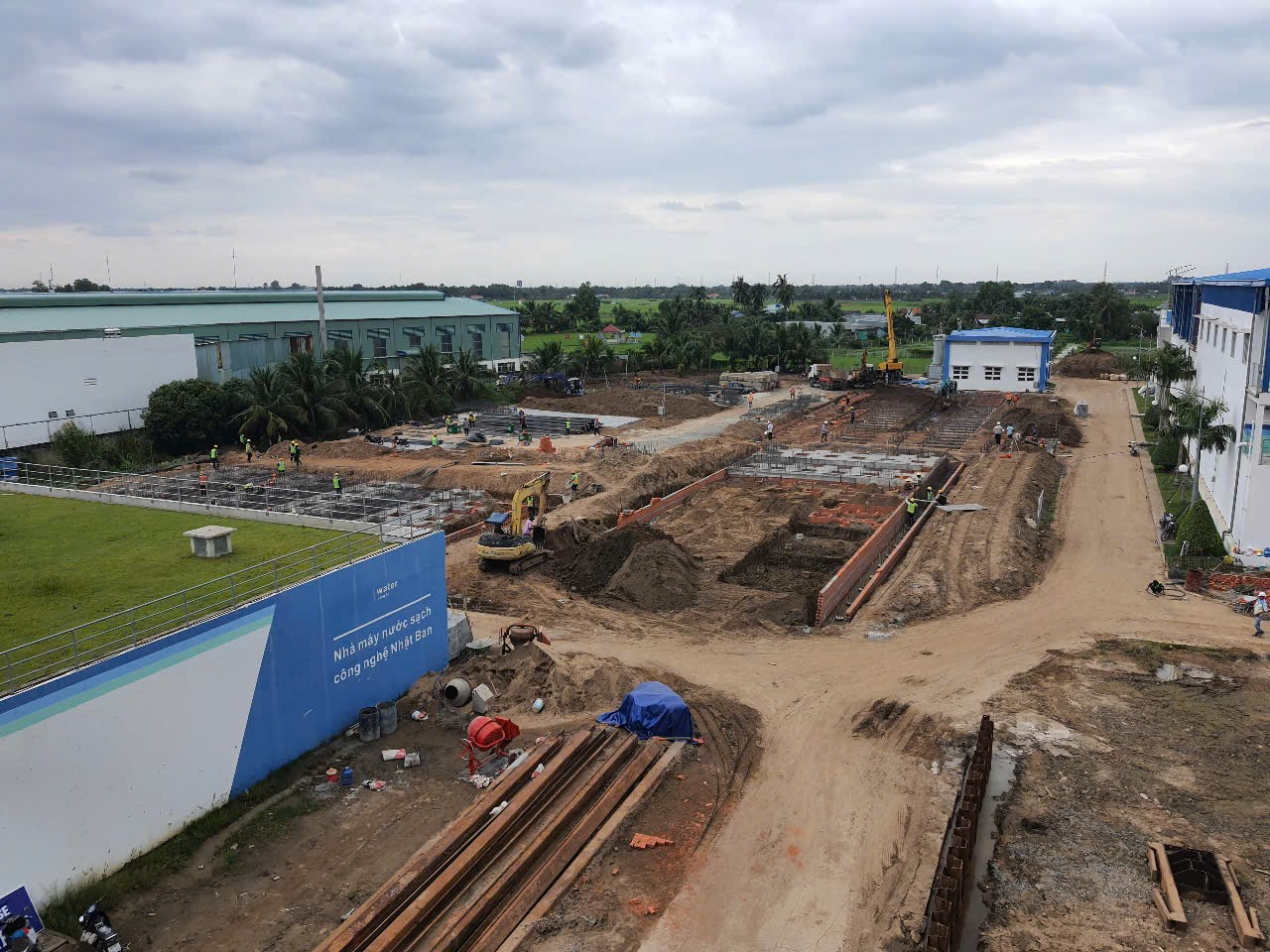

Foundation construction for treatment unit structures

Overall construction of treatment unit structures

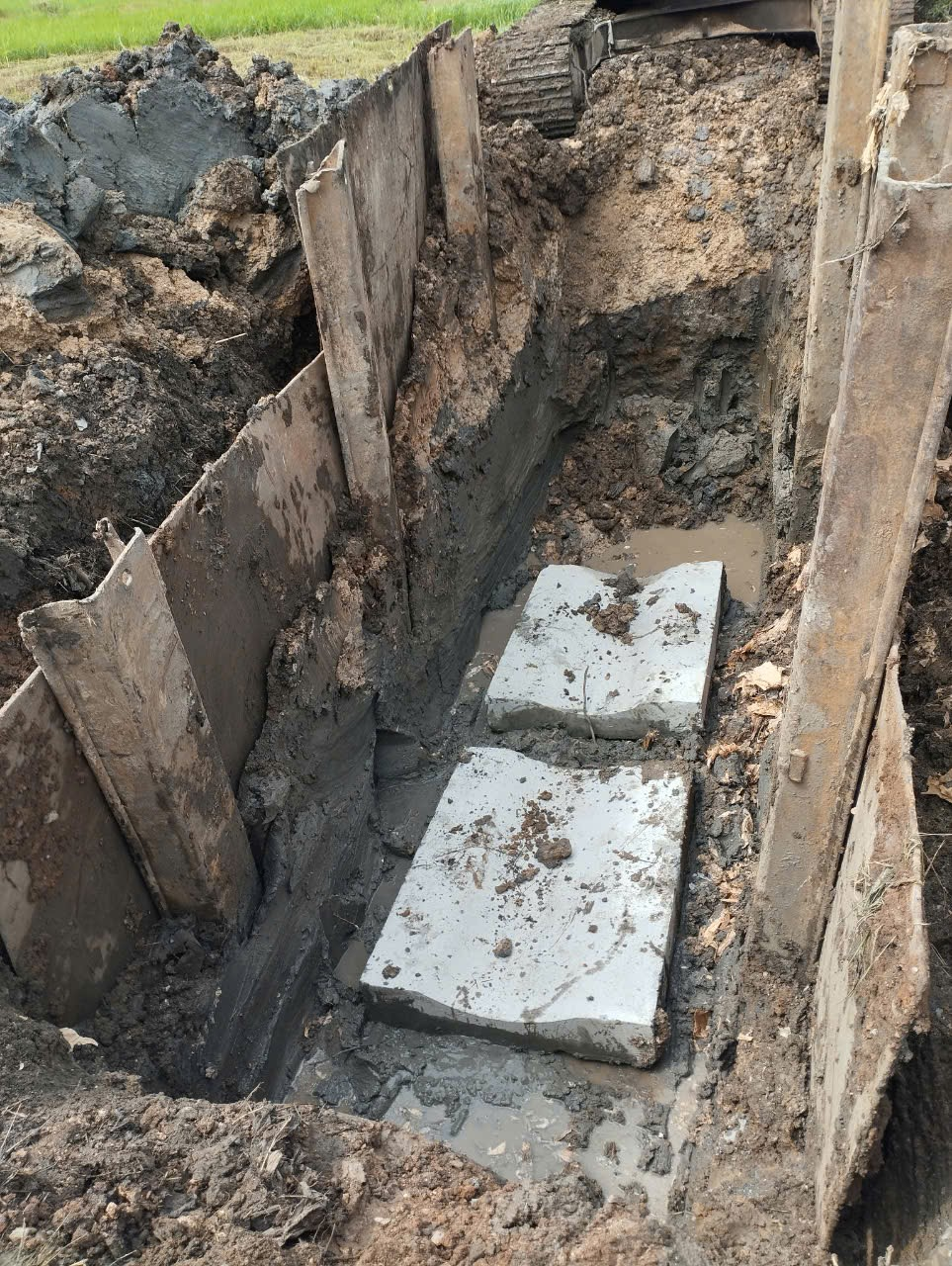

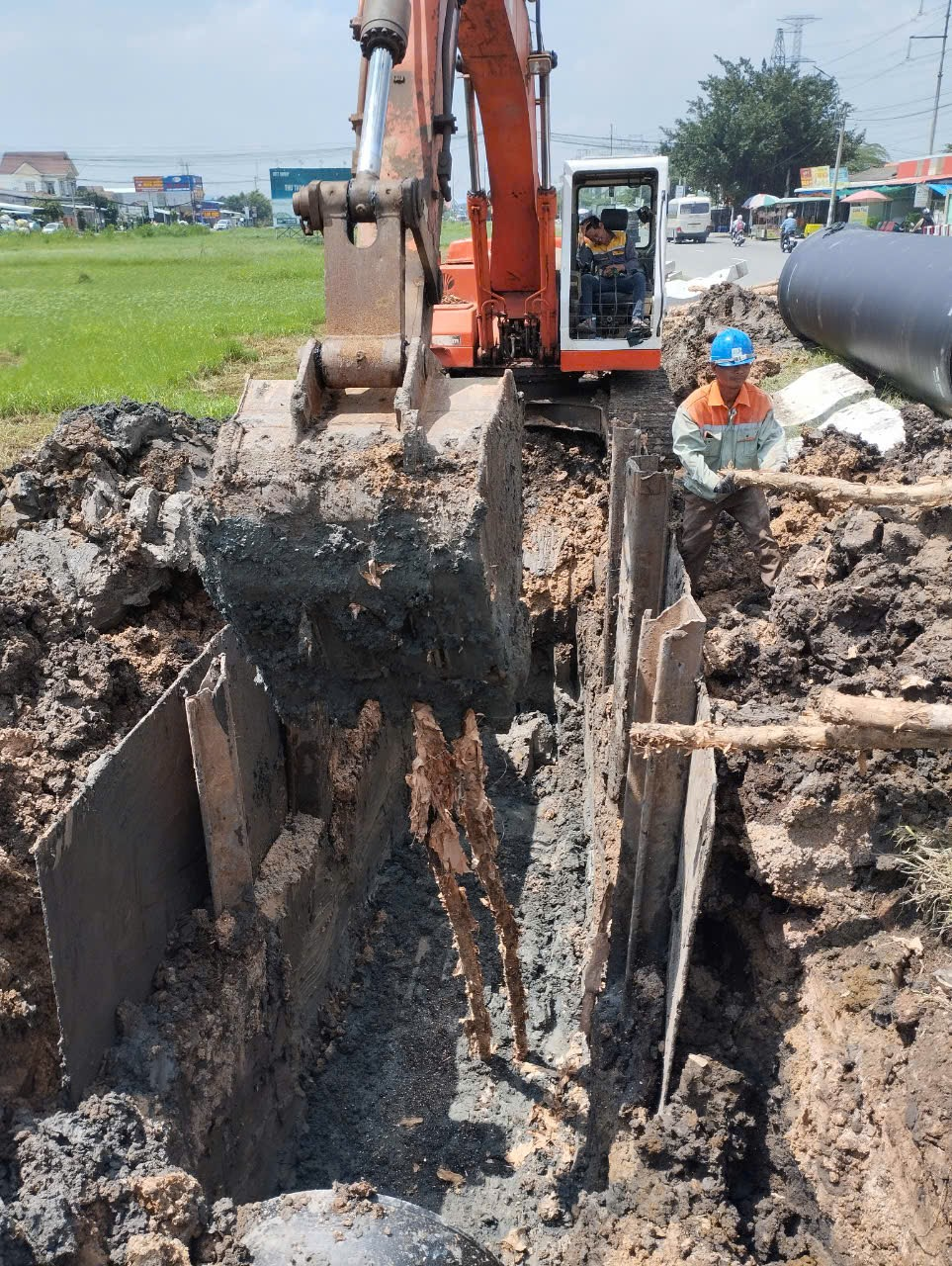

Pile driving for reservoir structures
2. Construction of D1200 raw water pipeline on DT818 road, Nhi Thanh Commune, Thu Thua District

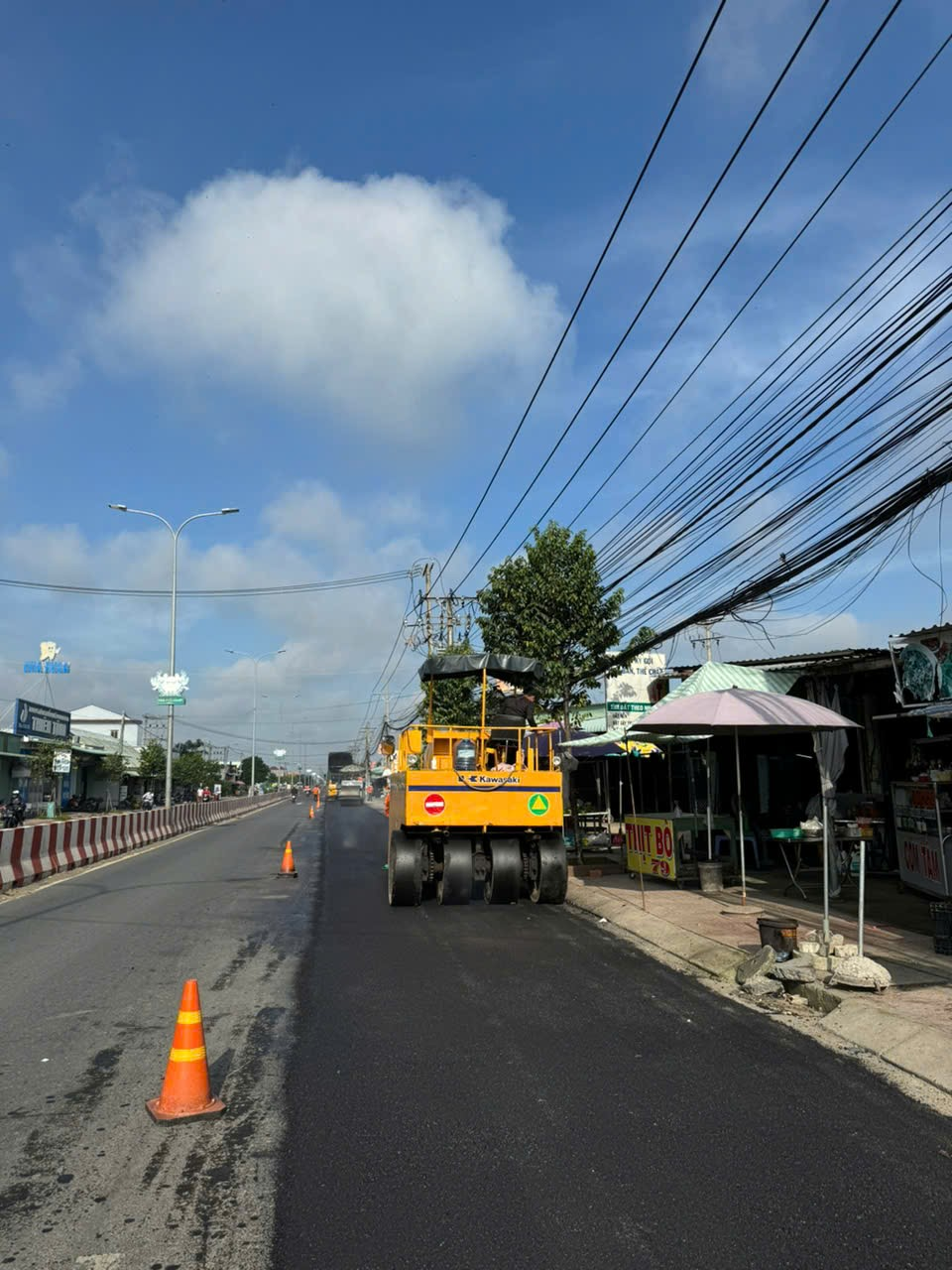

Asphalt restoration of excavated areas
3. Construction of D1200 clean water pipeline on National Highway 1A

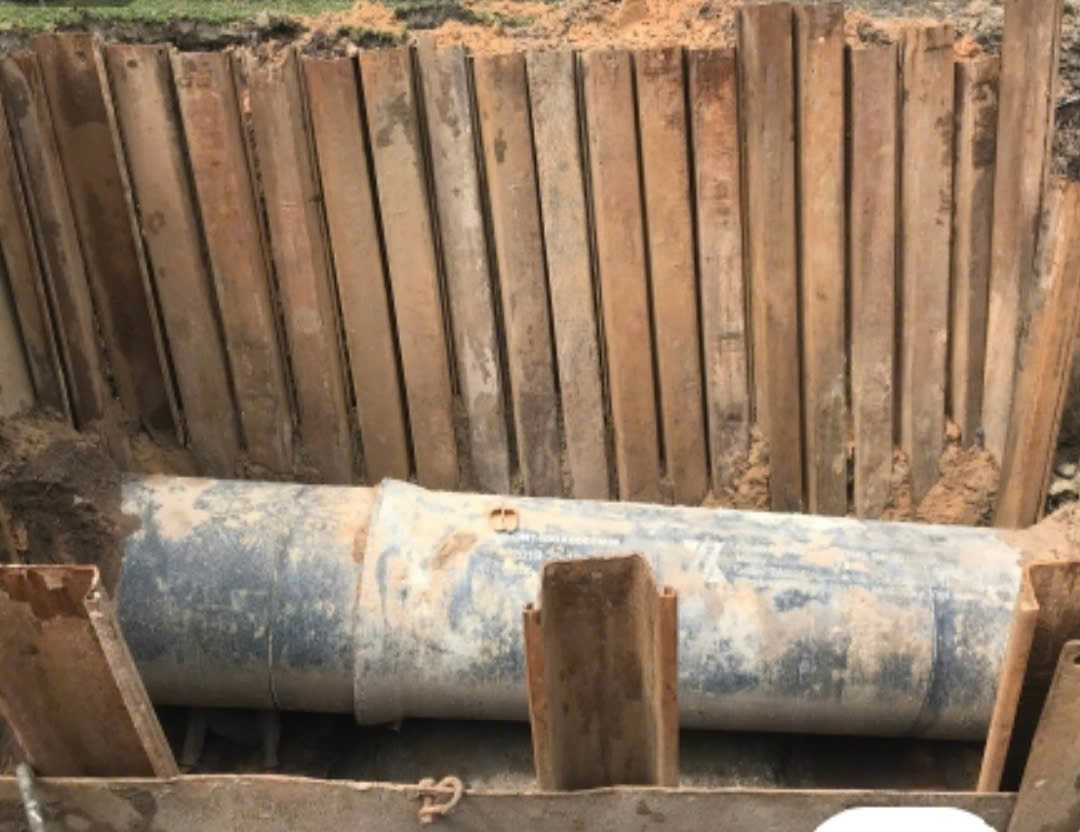

Melaleuca pile driving for excavated areas

Installation of concrete pipe support blocks

Installation of D1200mm cast iron pipes

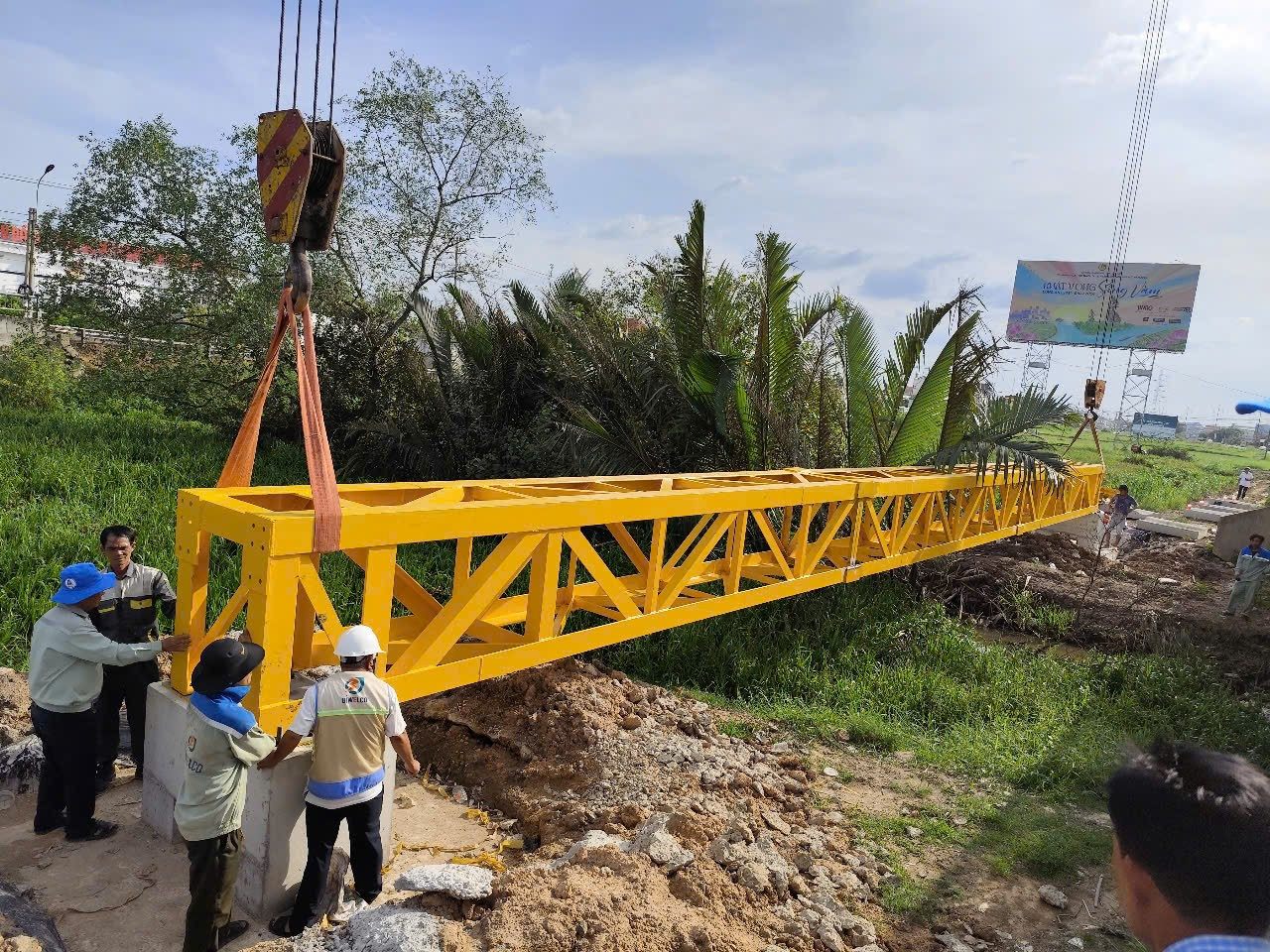

Installation of steel frames for supporting D1200mm cast iron pipes Across Van bridge, National Highway 1A

Installation of fencing, traffic Safety Signs, and traffic management measures
Investment Projects / Constructions Other
Date: 29-11-2024
